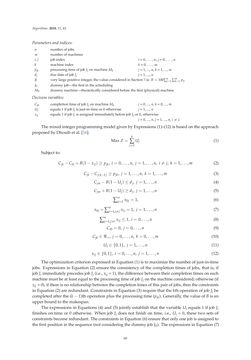

Algorithms 2018,11, 43
Parametersand indices:
n numberof jobs
m numberofmachines
i, j job index i=0, . . . ,n, j=0, . . . ,n
k machine index k=0, . . . ,m
pjk processingtimeof job JjonmachineMk j=1, ...,n,k=1, ...,m
dj duedateof job Jj j=1, ...,n
B very largepositive integer, thevalueconsidered inSection5 is:B=100∑nj=1∑ m
k=1pij
J0 dummyjob—thefirst in thescheduling
M0 dummymachine—theoreticallyconsideredbefore thefirst (physical)machine
Decisionvariables:
Cjk completiontimeof job JjonmachineMk j=0, ...,n,k=0, ...,m
Uj equals1 if job Jj is just-in-timeor0otherwise j=1, ...,n
xij equals1 if job Ji isassignedimmediatelybefore job Jjor0,otherwise
j=0, ...,n, j=1, ...,n, i = j.
ThemixedintegerprogrammingmodelgivenbyExpressions (1)–(12) isbasedontheapproach
proposedbyDhouibetal. [16].
MaxZ= n
∑
j=1 Uj (1)
Subject to:
Cjk−Cik+B(1−xij)≥ pjk, i=0,. . . ,n, j=1,. . . ,n, i = j, k=1,. . . ,m (2)
Cjk−Cj(k−1)≥ pjk, j=1,. . . ,n, k=1,. . . ,m (3)
Cjm−B(1−Uj)≤ dj, j=1,. . . ,n (4)
Cjm+B(1−Uj)≥ dj, j=1,. . . ,n (5)
∑nj=1x0j=1, (6)
x0j+∑ni=1,i =j xij=1, j=1,. . . ,n (7)
∑nj=1,j =i xij≤1, i=0,. . . ,n (8)
Cj0=0, j=0,. . . ,n (9)
Cjk∈ +, j=0,. . . ,n, k=0,. . . ,m (10)
Uj∈{0,1}, j=1,. . . ,n (11)
xij∈{0,1}, i=0,. . . ,n, j=1,. . . ,n (12)
TheoptimizationcriterionexpressedinEquation(1) is tomaximize thenumberof just-in-time
jobs. Expressions inEquation (2) ensure the consistencyof the completion timesof jobs, that is, if
job Ji immediatelyprecedes job Jj (i.e.,xij=1), thedifferencebetweentheircompletiontimesoneach
machinemustbeat leastequal to theprocessingtimeof job Jjonthemachineconsidered;otherwise (if
xij=0), if there isnorelationshipbetweenthecompletiontimesof thispairof jobs, thentheconstraints
inEquation(2)areredundant.Constraints inEquation(3) require that thekthoperationof job Jjbe
completedafter the (k−1)thoperationplus theprocessingtime(pjk).Generally, thevalueofB isan
upperboundto themakespan.
Theexpressions inEquations (4) and (5) jointly establish that thevariableUj equals 1 if job Jj
finishes on timeor 0otherwise. When job Jj doesnotfinishon time, i.e.,Uj =0, these two sets of
constraintsbecomeredundant. Theconstraints inEquation(6)ensure thatonlyone job isassignedto
thefirstposition in thesequence (notconsideringthedummyjob J0). Theexpressions inEquation(7)
